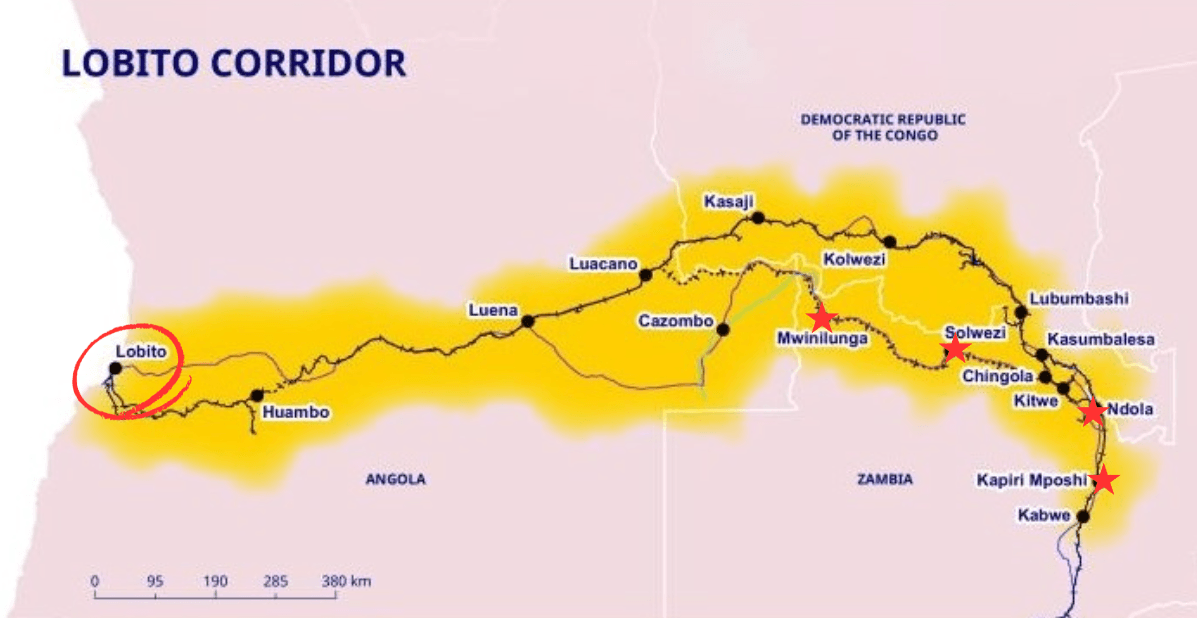

Lobito CorridorAtlantic gateway re-wiring the Copperbelt's export logic.
A 1,300 km rehabilitated railway in Angola, an 800 km greenfield link into Zambia and a multi-billion dollar blended finance stack are turning Lobito into a strategic alternative to Durban and Dar es Salaam for critical minerals, agriculture and regional trade.
This console distills multilateral documents, think tank analysis and industry data into a pragmatic view of how the corridor actually works for capital deployment.

Benguela Railway & Port of Lobito
Rebuilt with Chinese capital, now operated by a Trafigura-led consortium and positioned as the Atlantic outlet for the Copperbelt.
Corridor Snapshot
Benguela Railway rebuilt with Chinese capital and now operated under a 30-year concession by Lobito Atlantic Railway.
Greenfield rail from Luacano (Angola) to Chingola (Zambia) via Jimbe border, targeting groundbreaking in 2026.
Blended finance stack led by AfDB, AFC, DFC and Team Europe for corridor upgrades and extensions.
Trial shipments show ~8 days to Lobito vs ~25–30 days by truck to Durban for Copperbelt exports.
Weekly Intelligence
Live signals from the corridor ecosystem. Powered by CopperCloud Analytics.
How the Corridor Transforms the System
LevrAge views the Lobito Corridor not just as a track, but as a Value Stack. Using the Zambia Value Systems Framework (ZVSF), we identify projects that don't just use the infrastructure, but strengthen the entire national architecture.
Layer 1: The Spine (Logistics)
1,300km rail + Port of Lobito. The physical hardware moving copper out and capital goods in.
Layer 2: The Engine (Energy)
Solar & Hydro nodes along the track. Powering the mines and the electric rail traction.
Layer 3: The Nervous System (Digital)
Fiber optic backbone running parallel to rail. High-speed data for logistics and communities.
Layer 4: The Value (Industrial)
Refineries, Smelters, and Ag-processing. The 'stickiness' that turns transit into GDP.
Zambia's "Dubai Decade"
Just as Dubai leveraged its port to build a global logistics and finance hub, Zambia is using Lobito to pivot from "landlocked" to "land-linked." This corridor is the spine of that transformation.
Investors who align with this stack—building power for the rail, or processing at the nodes—receive higher policy support and SVS impact scores.
System Spillover Effect
From Colonial Rail to PGI Flagship
The Lobito Corridor is not a new line on a map—it is the latest iteration of a century-old project. The Benguela Railway was originally built between 1902 and 1931 to move copper and cobalt from the then Belgian Congo and Northern Rhodesia to the Atlantic. Civil war in Angola collapsed the system; by the early 2000s only a coastal fragment remained in service.
In the 2000s, China financed a US$2 billion reconstruction as part of a "rail-for-oil" program, fully relaying 1,300 km of track and 67 stations. The rebuilt line was technically impressive but commercially underused—a stark reminder that hard infrastructure without regional agreements and anchor freight is not enough. Today, the G7 Partnership for Global Infrastructure and Investment (PGI) is layering governance, blended finance and new greenfield links on top of that physical spine.
PGI & Global Gateway Stack
The corridor is the flagship African project for the G7's PGI and the EU's Global Gateway programs. Key pieces include:
- • US International Development Finance Corporation (DFC) loan of up to US$553M to the Lobito Atlantic Railway consortium for brownfield rehab and operations.
- • African Development Bank leading approximately US$500M in financing with a corridor program of ~US$1.6B.
- • Africa Finance Corporation (AFC) as lead project developer for the Zambia greenfield link, anchoring up to US$500M and managing feasibility and ESIA work.
- • Team Europe commitments (EU, Italy, UK) for grants, equity and debt, including targeted support for the Zambia segment and agriculture/logistics platforms.
Governance: Two Tracks, One Corridor
The corridor is governed on two intertwined tracks:
- • LCTTFA Agreement: Angola, DRC and Zambia's Lobito Corridor Transit Transport Facilitation Agency handles customs harmonisation, trade facilitation and the "soft infrastructure" that makes the corridor usable.
- • Seven-party MoU: host governments plus U.S., EU, AfDB and AFC coordinate financing and project development under PGI and Global Gateway.
- • Concession model: Angola granted a 30-year concession (extendable to 50) to the Lobito Atlantic Railway consortium—Trafigura, Mota-Engil and Vecturis—with the extension contingent on building the Zambia link.
Plugging the Copperbelt into the Atlantic
The greenfield Zambia–Lobito line is the economic heart of the project. An approximately 800 km rail link will connect the Benguela line at Luacano, Angola to Chingola in Zambia's Copperbelt via the Jimbe border. For the first time, Zambia will have a direct rail connection to an Atlantic deep-water port.
AFC as Lead Developer
The Africa Finance Corporation is leading development of the Zambia link:
- • Completed feasibility studies confirming economic viability and entered a concession agreement with Angola and Zambia.
- • Mobilising up to US$500M of its own and co-financed capital into the greenfield segment.
- • Supported by a USTDA ESIA grant to align with international environmental and social standards.
- • Targeting groundbreaking in early 2026 and commissioning by 2029.
Anchored Freight & Value Addition
The corridor isn't being built on speculation—anchor commitments are already in place:
- • KoBold Metals' Mingomba project and other Copperbelt mines have signed MoUs totalling ~470,000 tonnes of annual freight.
- • Kobaloni Energy's planned cobalt sulphate refinery in Zambia is explicitly modelled around access to Lobito and renewables-powered processing.
- • These commitments underwrite the economics of the line and create a platform for additional refineries, cathode plants and logistics hubs.
Lobito Corridor Opportunity Matrix
Where capital meets the corridor. We track active investment windows across the value chain.
Upstream (Mining)
Copper, Cobalt, and Nickel exploration in NW Province.
- Greenfield Exploration
- Brownfield Expansion
- Tailings Reprocessing
Midstream (Processing)
Refineries and smelters to capture value before export.
- Copper Smelters
- Cobalt Sulfate Plants
- Cathode Manufacturing
Downstream (Logistics)
Warehousing, cold chain, and last-mile transport.
- Dry Ports
- Cold Storage
- Fleet Management
Enablers (Power & Tech)
Infrastructure that powers the corridor.
- Solar Farms (>50MW)
- Fiber Optic Links
- Industrial Parks
Why Lobito Changes the Math
For Copperbelt producers, the core question is simple: how fast, how reliable and at what cost can product reach port? The answer is shifting away from Durban and Dar es Salaam towards Lobito.
Lobito Corridor
- • Rail-based, open-access corridor.
- • ~8–10 days to Atlantic port from Copperbelt.
- • Backed by PGI and EU Global Gateway.
- • Growing anchor freight and logistics ecosystem.
Durban / North–South Corridor
- • Heavy reliance on trucking over 2,000+ km.
- • ~25–30 days end-to-end in practice.
- • Severe border queues and port congestion.
- • Exposure to strikes and social unrest.
TAZARA & Other Corridors
- • Dar es Salaam and Beira routes remain relevant.
- • Rail and port infrastructure need ongoing rehab.
- • Transit times ~20–25 days under good conditions.
- • Stronger alignment with Asia-facing flows.
Corridor Impact Score (SVS)
How does your project strengthen the system? LevrAge uses the System Value Score to quantify your project's impact, helping you unlock DFI capital and government incentives.
| Category | Weight | Score | Key Metric |
|---|---|---|---|
| Strategic Fit | 30% | High | Aligns with ZDA 2025 Mining Targets |
| Value Addition | 25% | Med | Partial local processing proposed |
| Infrastructure | 20% | High | Contributes 50MW to local grid |
| Social Impact | 15% | High | 500+ local jobs in NW Province |
| Env. Resilience | 10% | Med | Standard ESIA compliance |
Why SVS Matters
- DFI Alignment: Matches AfDB/AFC impact frameworks.
- Incentive Access: High SVS scores fast-track ZDA negotiations.
- Social License: Quantifies community benefit beyond tax.
Available for projects >$10M CAPEX
Corridor Timeline
From colonial extraction to modern integration.
Construction Begins
Benguela Railway starts to link Katanga mines to the Atlantic.
Civil War Halt
Angolan Civil War effectively closes the corridor for decades.
Chinese Reconstruction
CR20 completes $1.8B rebuild of the Angolan line.
Concession Awarded
Trafigura-Mota-Engil consortium wins 30-year operating rights.
US/EU PGI Backing
Biden & Von der Leyen announce major financing support.
Zambia Groundbreaking
Target start for the greenfield Jimbe-Chingola link.
Full Connectivity
Rail operational from Kolwezi to Lobito via Zambia.
Key Risks & Open Questions
The Lobito Corridor is a high-upside, high-complexity system. Any serious strategy needs a clear view of its vulnerabilities.
Security & Informal Economies (DRC)
The eastern section passes through areas where entrenched informal trucking, artisanal mining and criminal networks profit from the status quo and may resist modal shift to rail.
Border & Regulatory Bottlenecks
The Jimbe border is a known weak link: customs and road infrastructure are currently asymmetric between Angola and Zambia and require aligned policy plus capital to be truly corridor-ready.
Western Political & Funding Volatility
PGI commitments are substantial but exposed to changing U.S. and European political cycles, which can delay feasibility work, soft-infrastructure reforms and disbursements.
Is your logistics plan ZECS-verified?
Don't let border bottlenecks surprise you. Check your readiness score.
This analysis is informational only and does not constitute investment advice or a guarantee of project completion. Stakeholders should pair intelligence like this with on-the-ground due diligence, updated legal/ESG assessments and independent financial modelling.
2024–2029: What to Watch
For investors, operators and policymakers, the following milestones will shape how real the corridor becomes.
Position Your Strategy on the Lobito Corridor
Whether you're evaluating a mining project, a refinery, a logistics hub or a data/energy play, the corridor changes the execution map for Zambia and the broader Copperbelt. LevrAge can help translate this intelligence into action.
For deeper technical notes, source citations or integration into your internal memos, we can adapt this corridor brief into investor decks, credit memos or policy summaries tailored to your stakeholders.
